The Friday Meeting Nobody Expected to Explain

It is Friday afternoon in the weekly site meeting, and the electrical coordinator is presenting progress to the project sponsor. Seventy-eight percent of cables have been pulled. The percentage sits cleanly on the slide, and the sponsor nods. The schedule looks recoverable. Three weeks later, the reality has shifted. The vessel is behind schedule. The delay is real, and the explanation is uncomfortable: the cables that remained were heavy armored feeders routed through the most congested sections of the engine room. Those cables alone were going to require three times the pulling labor per meter compared to anything completed earlier in the project. A cable points workload metric exposes exactly this gap before it becomes a missed deadline.

The piece-count report never revealed this problem. It counted every cable as one unit, treating a 2-core signal wire and a 37-core armored power feeder as equivalent effort. They are not equivalent. The labor intensity difference between them can be an order of magnitude. When you multiply that gap across thousands of cables on a large vessel, distributed across dozens of contractors and multiple decks, the cumulative distortion in your progress picture becomes dangerous. The coordinator who presented 78% pulled was not misreporting. The metric itself was fundamentally misleading.

This is the core failure of workload calculation in shipbuilding when it relies solely on piece counts. Cable Points workload metric solves this problem by replacing simple counts with objective calculation of actual labor intensity.

The Invisible Problem: Why Piece Counts Destroy Visibility

The problem compounds as projects scale in size and complexity. At the vessel level, the deck level, and the discipline level, wherever a coordinator is trying to forecast true remaining effort, piece counts and raw cable length give the same distorted answer.

A system report states that 60% of cables have been installed on Deck 4. But if the remaining 40% are predominantly high-cross-section power feeders passing through machinery spaces with restricted cable tray access, then 60% represents far less than 60% of the actual work remaining. The project manager is flying blind with numbers that appear solid but mask hidden risk.

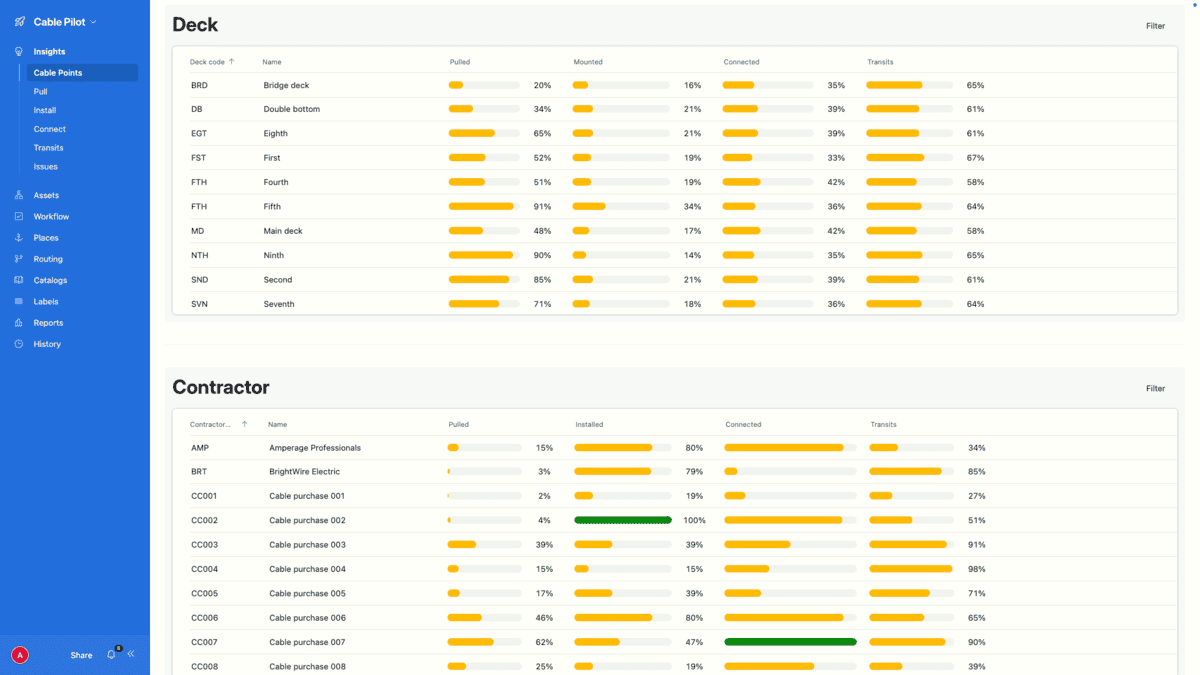

Cable Pilot Cable Points metrics table by deck and contractor with progress bars

Consider a second scenario: two contractors working on the same vessel both report 500 cables pulled. One contractor has been working through open compartment runs with generous routing space. The other has been grinding through the restricted engine room zones where every cable requires manual bending, rotation, and careful tray placement. The piece-count report shows them as equal performers. The first contractor has cleared the easy work. The second is facing months more of difficult pulling. Which metrics reveal this? None, under a piece-count system.

The consequence is predictable. Schedule forecasts miss by weeks. Resource allocation decisions are made without understanding true bottleneck areas. Contractor performance discussions devolve into arguments about conditions rather than measurable progress. The coordinator cannot answer the most fundamental question: given the work completed this week and the work remaining, when will this electrical installation actually be finished?

Cable Points Workload Metric: Calculation From Specification Data

Cable Points is the metric Cable Pilot applies to address this directly. It is not a figure entered manually by a foreman or an estimate derived from experience. Cable Points workload metric is calculated automatically from the cable’s own specification data, the same data imported into the platform from engineering documents.

Cable points workload metric dashboard in Cable Pilot showing total and done Cable Points by type

The calculation derives a workload value that reflects the true labor intensity of that specific cable, based on objective physical characteristics: cross-section area, core count, flexibility, armoring, and termination complexity. A heavy armored feeder carries substantially more Cable Points than a thin signal wire. The system knows this because the cable specification contains this information. The cable points workload metric draws every value from that specification, not from opinion.

For experienced coordinators who have attempted to build weighted progress metrics manually in spreadsheets, the concept is familiar. What changes with Cable Pilot is that the calculation is automatic, consistent, and applied simultaneously at every level of the project, from a single cable record to the entire vessel. There is no manual interpretation. There is no debate about whether a cable “counts” as equivalent effort. The specification decides.

How Cable Pilot Calculates Pulling Labor Intensity Calculation

Cable Pilot separates workload into two distinct categories: pulling labor intensity calculation and connection effort. These are calculated separately and tracked through the entire cable lifecycle. This separation matters because a cable that has been fully pulled through the vessel may still carry substantial remaining connection work. The work of physically moving cable from drum to tray is a different dimension from the work of terminating all cores at both ends.

For pulling workload, the formula is direct: calculated cable length multiplied by a pulling labor factor derived from the cable’s specification data. This pulling labor factor encodes the physical reality of the cable: weight per meter, rigidity, diameter relative to the tray width it passes through, and the space available at each routing section.

Cable Pilot Pull analytics showing Pulled Cable Points % by deck and contractor

Two cables of identical length but different specifications produce different Cable Points values. The system calculates baseline pulling CP at the specification level and then updates it as each cable progresses through stages: pulled, installed, connected, and marked done. At every point in the lifecycle, the coordinator views both absolute Cable Points values and the percentage of pulling work completed relative to total pulling workload.

The five distinct Cable Points states for pulling work are specification CP, total CP, in-work CP, pulled CP, and done CP. A cable might have 100 pulling CP in its specification but only 40 pulled CP after two days of actual work in the field. The dashboard shows this progression, not as abstract fractions but as workload actually completed. Each stage feeds the cable points workload metric with field-confirmed progress.

Connection Workload: The Second Dimension of Installation Effort

Connection workload is calculated separately from pulling effort. It derives from the cable’s termination characteristics: core count, termination type, connector style, and the complexity those attributes create. A cable that required two hours to pull across the vessel may require four hours to terminate properly at both ends if the cores are numerous and the termination devices are precision components.

The weighted cable progress measurement at the connection level applies the same five-stage framework: specification CP, total CP, in-work CP, connected CP, and done CP. Both absolute Cable Points and percentage ratios are displayed, showing connected CP as a proportion of total connection CP and done CP as a proportion of total. A cable can show 100% pulled while sitting at only 20% done in connection workload.

Equipment carries workload streams independent of cables. Mounting workload is calculated from the equipment’s physical attributes: mass and dimensions. Connection workload at the equipment level is derived from aggregating the complexity of all cables terminating at that specific piece of equipment. A large switchboard panel with 40 cable terminations accumulates substantial connection workload cable points. A small fuse holder with two terminations accumulates less.

From Cables to Entire Vessel: Workload Aggregation Across All Levels

The per-cable Cable Points values do not remain isolated at the cable record level. They roll up through the vessel hierarchy. At each level of aggregation, the same workload logic applies. A coordinator asking “What is the true remaining effort on Deck 3?” receives a CP-weighted answer, not a simple cable count.

At the vessel level, the system calculates and displays total pulling CP, pulled CP, installed CP, connected CP, and done CP for the entire build. The coordinator seeing the vessel summary immediately understands whether remaining effort concentrates in pulling or in connections and how far each workload type has advanced.

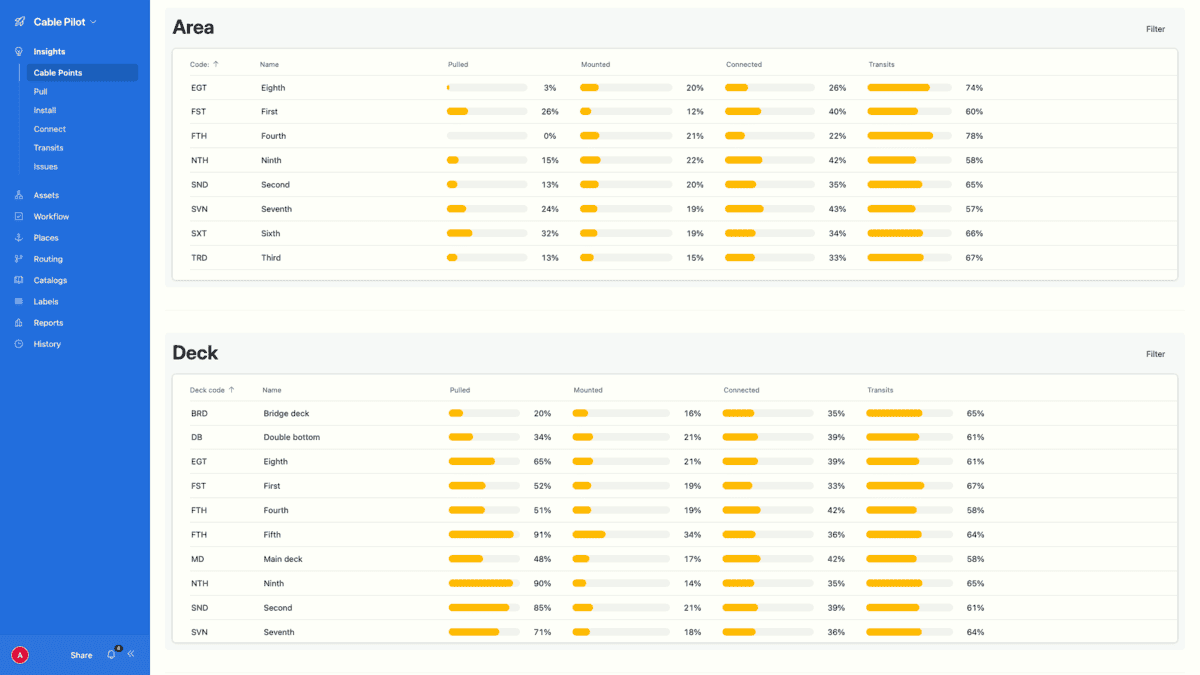

Cable Pilot Cable Points progress by area and deck with four-stage workflow bars

At the deck level, a critical distinction separates own cables from transit cables. Own cables originate and terminate on that deck. Transit cables pass through that deck en route to other destinations. This distinction prevents misattribution of effort. A deck hosting a major cable highway will show substantial transit Cable Points, but that labor does not belong to the team responsible for that deck’s resident equipment.

At the discipline level, connection workload breaks into the same five-stage structure in both absolute and relative values. At the system level, progress is tracked in both cable count and cable length, with weighted cable progress measurement capabilities. At the category level, the same Cable Points breakdown structure applies. Area-level workload aggregation gives coordinators the ability to interrogate progress by geographic zone within a deck.

This multi-level architecture means the coordinator is not forced to choose between a vessel-level view and a deck-level view. The same cable points contractor accountability metric is available at every resolution, from the individual cable record to the entire electrical system, and the answer at each level derives from the same calculation, not from different estimation methods at each tier. At every level the cable points workload metric returns one consistent answer.

The Cable Points Progress Dashboard: Seeing What Actually Remains

All of this calculation becomes visible in the Cable Points Progress dashboard on the web platform. When a coordinator opens the dashboard, the first visible elements are two KPI cards: total Cable Points for the project and done Cable Points. The gap between these numbers represents the project’s true remaining workload. This dashboard is the cable points workload metric made visible.

Below the KPI section, a donut chart breaks the remaining workload into component types: pulling, mounting, connections, and transits. The coordinator immediately sees which workload stream dominates what remains. A stacked status bar chart shows workload distribution across lifecycle stages. A weekly overview section surfaces recent progress trends week by week.

Scrolling further reveals deck- and contractor-level Cable Points tables. Each row shows percentage progress bars across stages: pulled, mounted, connected, and transits. The coordinator compares decks directly, seeing which are advancing through pulling and which lag in connections, and performs the same comparison across contractors on the same vessel.

Area and deck breakdown tables provide the same four-stage Cable Points progress view at finer geographic resolution. This is essential when a single deck contains distinct work zones with different teams or limited access windows.

The Pull Report: Contractor Accountability Through Cable Points

The Pull reporting screen surfaces pulled CP percentage alongside cable counts and total pulled length per deck and per contractor. This combination of volume and workload in a single view is where the distortion in piece-count reporting becomes immediately visible.

A contractor might show a high cable count and pulled length that appears competitive, while their pulled CP percentage trails behind because the cables they selected to work first were predominantly lighter runs. The weekly overlays Cable Points against pulled length over time, showing whether a team’s cable count translates into proportionate workload completion.

Connection Progress: Forecasting Termination Work Remaining

The connection workload cable points view surfaces live velocity metrics: average weekly connections completed, connections remaining, average workload per connection, and weeks-to-completion. When remaining Cable Points concentrate in heavy-effort cables, the forecast extends accordingly. The coordinator sees that extension immediately, not after deadline pressure forces disclosure.

The same standardized cable points contractor accountability formula applies to every contractor on the project. That removes the common rebuttal that different site conditions make performance comparisons unfair. The Cable Points calculation reflects the cable specification itself, not the contractor’s circumstances.

Blocked, failed, and damaged flags on cables and equipment propagate into all workload views. A contractor’s true net progress accounts for work rejected or stopped, not simply work recorded as complete.

Historical Data: Replacing Estimates With Measured Evidence

Historical Cable Points data from completed builds becomes the benchmark for future projects. This replaces subjective man-hour estimates with measured workload evidence from actual project execution. The next large vessel scheduled for electrical installation can import its cable specification, and Cable Pilot calculates total project Cable Points based on proven labor intensity factors from previous builds. The estimate is no longer a guess. It is derived from real performance on comparable cables. Past builds calibrate the cable points workload metric for the next vessel.

From Workload State to Completion Forecast

Knowing the true state of the project is necessary but not sufficient. The question that follows in every status meeting is: when will this be finished? Piece-count metrics cannot answer honestly because they cannot account for the labor intensity of work remaining.

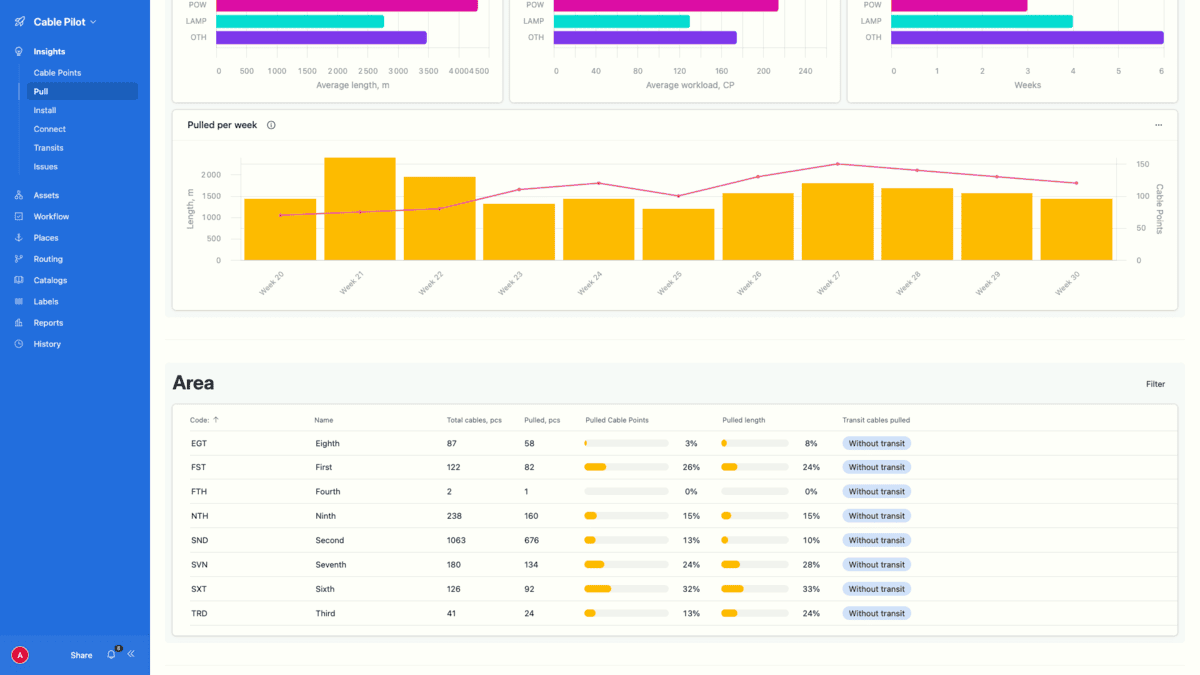

Cable Pilot Pull Insights weekly chart tracking Cable Points and pulled length

Because Cable Points measurement is continuous from field smartphone scans, the system calculates a team’s true CP velocity: how many Cable Points are completed per week. Remaining CP, defined as total CP minus done CP, divided by that weekly velocity, produces a weeks-to-completion figure that accounts for actual labor intensity of work remaining.

This forecast is not built on the assumption that remaining cables are as fast to complete as cables already pulled. It is built on measured data about what those cables actually require in workload terms.

The forecast updates with every field scan, not at end-of-shift reporting cycles. When remaining Cable Points concentrate heavily in difficult cables, as in the engine room scenario from the opening, the forecast extends accordingly. The coordinator sees that extension in advance.

Plan-fact analysis performed in Cable Points instead of cable count eliminates what some teams call the grand piano problem: the situation where 4% of remaining items carries 40% of actual effort. In a CP-weighted view, that concentration is visible immediately. The gap between a cable-count percentage and a CP percentage at the same project moment is itself a risk indicator, and it is always displayed for any coordinator watching.

The Risk Indicator That Saves Three Weeks

Return to the Friday meeting with the Cable Points dashboard open. The vessel-level summary shows 78% of cables pulled by count, yet only 54% of pulling Cable Points completed. The gap between these two numbers is the story the previous meeting missed.

Drilling into the deck table makes the concentration visible. The engine room zone shows 60% of remaining pulling Cable Points in one area, worked by a contractor whose weekly CP velocity has declined over three weeks. That combination—high remaining Cable Points, shrinking throughput rate—describes a risk the coordinator can act on immediately, not after schedule delay materializes.

All data originated from field smartphone scans, timestamped as work was recorded on the deck. The coordinator did not assemble it from contractor self-reports or estimate it from inspection rounds. It is objective, continuous, and current. The corrective conversation with the contractor, the resource reallocation, the schedule adjustment—all can happen three weeks earlier than under a piece-count regime.

The cable list in Cable Pilot carries specification data that feeds every Cable Points calculation. As each cable progresses from specification to pulled to connected to done, the workload values in every dashboard update automatically. Nothing is manual. Nothing is estimated at the team level.

See Your True Workload Before the Next Meeting

If you want to see what cable points workload metric looks like applied to your specific vessel, your contractor structure, and your actual deck layout, Cable Pilot can calculate the weighted cable progress measurement on your data before the next site meeting. Input your cable list, specify your equipment, and the system calculates total Cable Points immediately.

That calculation is the most direct way to understand where piece-count reporting may be understating the labor required to complete your electrical installation. It replaces Friday’s reassuring number with a number you can defend.

Cable Pilot’s weighted cable progress measurement approach transforms how shipyard project managers forecast completion and allocate resources. The cable points contractor accountability structure ensures every team is measured on actual work completed, not simple counts that hide difficulty. When your next electrical installation faces the engine room question—how much pulling labor really remains in those heavy feeders—the cable points workload metric gives you the answer before it becomes a missed deadline.

Contact Cable Pilot to run a Cable Points analysis on your vessel data and see how weighted cable progress measurement changes your project visibility. The gap between your current 78% and your actual progress may be larger than you think.
